5 Marla House Construction Cost in Lahore: A DHA Budget Guide

5 Marla House Construction Cost in Lahore: A DHA Budget Guide

A useful starting benchmark for 5 marla house construction cost in Lahore is PKR 95.44 lakh, based on Zameen’s double-story calculator estimate dated 1 October 2026. That figure is a planning reference, not a fixed quotation for a house in DHA Lahore. Your approved covered area, specifications, site conditions and contractor’s scope determine the actual budget. For a DHA homeowner, the important question is what it will cost to complete the house you intend to build. A construction estimate needs to show the work included, the expenses left outside it and the cash required as construction progresses.

What Does the Latest Published Benchmark Include?


Zameen’s 5 marla Lahore construction calculator displays the following breakdown, with prices marked as updated on 1 October 2026:

Cost Component

Published Estimate

Grey structure materials

PKR 48.52 lakh

Finishing materials

PKR 36.89 lakh

Labour

PKR 10.02 lakh

Displayed total

PKR 95.44 lakh

Displayed cost per square foot

PKR 4,713

The rounded component figures add to PKR 95.43 lakh, which is PKR 1,000 below the displayed total. The calculator describes the estimate as being for a double-story house and warns that market prices can change. It is not a DHA-approved design or a binding contractor offer. Treat land purchase as a separate budget; do not assume professional fees, approvals, utility connections or optional features are covered without checking the scope. The PKR 48.52 lakh figure is specifically labeled grey structure material cost. It should not be presented as the complete labor-inclusive cost of delivering the grey structure.

Start With Covered Area, Not Plot Size Alone

  • Five marla describes the plot category. Contractors commonly price construction by covered area, which can span multiple floors.

  • Two houses on similar plots can cost different amounts because their approved designs include different amounts of construction. Floor layouts, basements, stair arrangements, and structural requirements can change both quantities and the work involved.

  • Ask the designer and contractor to agree on a floor-by-floor area statement. The quotation should explain how it measures each chargeable area, including any separately priced spaces or features.

  • For illustration, an additional 200 square feet at an assumed PKR 5,000 per square foot adds PKR 10 lakh. Neither figure is a market quotation; the calculation shows why an unexplained difference in covered area can matter more than a small discount in the quoted rate.

Separate Grey Structure From Finishing

A grey structure quote and a finished-house quote cover different stages. Even two quotations described as “grey structure” may include different work. Use the proposed drawings and written specifications to establish the boundary between packages.

Package

Items to Clarify in the Quotation

Grey structure

Excavation, foundations, structural frame, masonry, plaster and specified waterproofing

Concealed services

Plumbing lines, electrical conduits and which installation stages are included

Finishing

Flooring, paint, doors, windows, cabinetry, sanitary fittings and electrical fixtures

External works

Boundary works, gate, driveway, drainage and landscaping where applicable

Optional features

Basement, solar system, air conditioning, appliances and other specified additions

These are comparison categories, not a universal definition of every contractor’s package. Avoid accepting “A-grade finishing” as the complete specification. Ask for product descriptions, quantities and allowances. A tile allowance per square foot or a defined sanitary-fixture budget is easier to compare than a quality label with no measurable limit.

Account for DHA Lahore’s Preconstruction Requirements

DHA Lahore’s Building Control guidance lists documents for drawing submission, including the site plan, professional stability certificates and a soil or geotechnical report. It also places demarcation after building-plan approval. These steps affect the budget and the start date. Identify who will arrange the drawings, investigations, submissions and required records, and whether their charges are included in the contractor’s offer. A basement needs particular attention. DHA’s published guidance lists additional basement-related documentation, while its Building Control forms directory includes basement undertakings and a sample construction method. Price a proposed basement against its design and site requirements. A standard above-ground rate does not explain the scope of excavation, retaining structures or waterproofing. Obtain the applicable requirements and current charges for your case before committing to the work.

Compare Contractor Quotes on the Same Scope

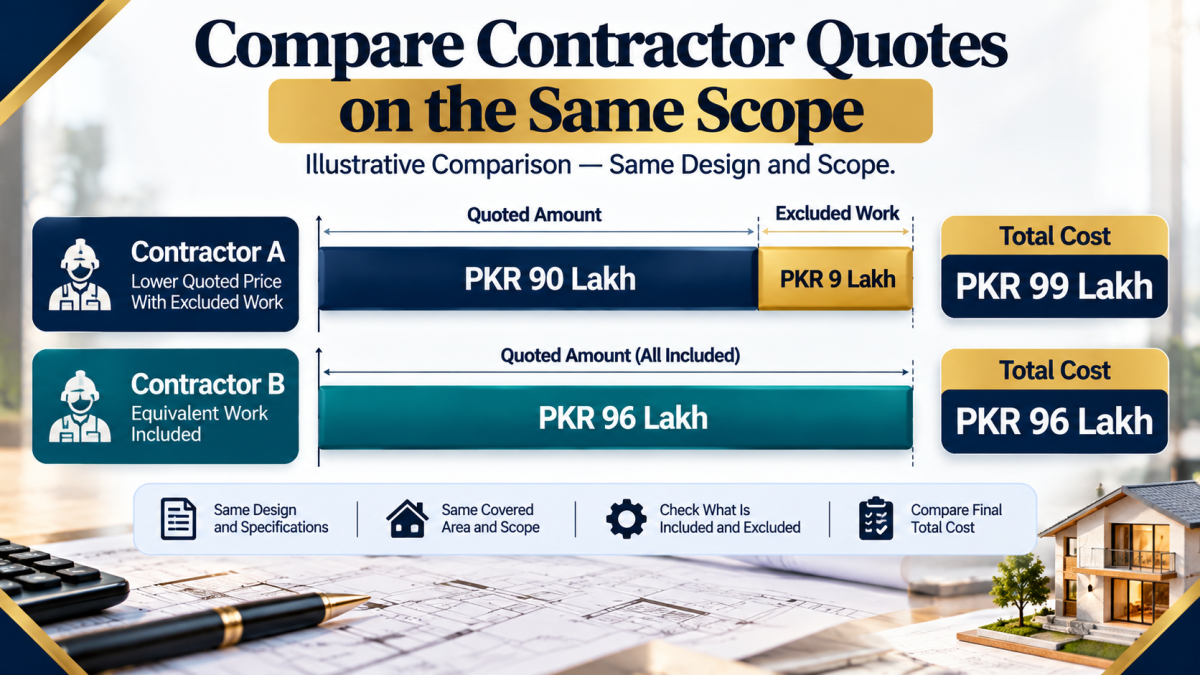

The lowest headline rate is useful only when the quotations include comparable work. Consider two hypothetical offers for the same design:

Quotation Component

Contractor A

Contractor B

Quoted construction package

PKR 90 lakh

PKR 96 lakh

Additional work needed to match the agreed scope

PKR 9 lakh

Included

Comparable construction total

PKR 99 lakh

PKR 96 lakh

In this example, Contractor A’s excluded work reverses the apparent saving. Both offers must still be checked for equivalent materials, quantities, workmanship obligations and payment terms. Ask each contractor to identify exclusions explicitly. Also establish how material substitutions, owner-requested changes and price movements will be handled. Record who approves additional work and how its cost will be agreed before execution. The goal is a quotation you can compare line by line against the house you expect to receive.

Build the Full Project Budget Before Work Starts

Once the construction scope is consistent, assemble the remaining project costs without double-counting anything.

Full Project Budget = Agreed Construction Scope + Excluded Project Costs + Contingency

Excluded costs may include design and professional services, authority charges, utility arrangements or owner-supplied items. Their treatment depends on the contract. An item already included in the construction package should not be added again.

Keep a contingency separate from the contractor’s price. Its size should reflect unresolved design decisions, site uncertainty and the contract’s treatment of changes. A clearly specified project and one with an undecided basement should not automatically receive the same allowance.

Then translate the budget into payments. Ask for a schedule tied to defined stages of work, along with the amounts needed for major purchases and owner-supplied items. Include your household’s accommodation costs if you will be renting elsewhere during construction. A project can be affordable overall but hard to fund if it requires too much money at the same stage.

Set Your Budget Around the House You Will Actually Build

The PKR 95.44 lakh published benchmark is a useful opening reference. Your working budget should come from the approved design, measured covered area and a quotation that identifies its inclusions and exclusions. Compare equivalent specifications, add the project costs outside the construction package and retain an allowance for unresolved work. This gives you a more useful starting point than applying one rate to every 5 marla house. To discuss your DHA Lahore construction requirement, contact Aslaaf Builders with your phase, plot details, proposed covered area, drawings if available and preferred finish level. Call 0321-8433312 or 0321-4333103.

FAQs About 5 Marla House Construction Cost in Lahore

How Much Does a 5 Marla House Cost to Build in Lahore?

Zameen’s calculator displays a PKR 95.44 lakh double-storey estimate dated 1 October 2026. Your project may differ because of covered area, specifications, site conditions and the work included in the quotation.

Does the Construction Estimate Include the Plot Price?

Keep land purchase separate. The benchmark discussed here concerns construction; it should not be treated as the combined cost of acquiring a plot and building a house.

Is Grey Structure Material Cost the Complete Grey Structure Budget?

No. A material-only figure does not establish the labour-inclusive package cost. Check labour, equipment, supervision and exclusions in the contractor’s written quotation.

Can I Apply One Per-Square-Foot Rate to Every Floor?

Only where the quotation defines that pricing basis and covers the relevant work. Basements and other special features need their scope and pricing clarified separately.

How Can I Compare Two Builders’ Quotations Fairly?

Use the same drawings, measured covered area and specifications. Add excluded work to each offer, then compare payment terms and the treatment of variations alongside the total.
